HS2 Engineers Complete Bridge Installation Over Grand Union Canal Ahead of Schedule
HS2 Bridge Over Canal Installed Ahead of Schedule

HS2 Engineers Successfully Slide Major Bridge Over Grand Union Canal Ahead of Schedule

In a significant engineering achievement, HS2 workers have completed the installation of a massive steel bridge over the Grand Union Canal in Warwickshire, finishing the operation a full week ahead of the planned schedule. The complex manoeuvre involved sliding a 130-metre long, 1,620-tonne bridge deck into position, marking a crucial milestone for the high-speed rail project.

Precision Engineering Operation

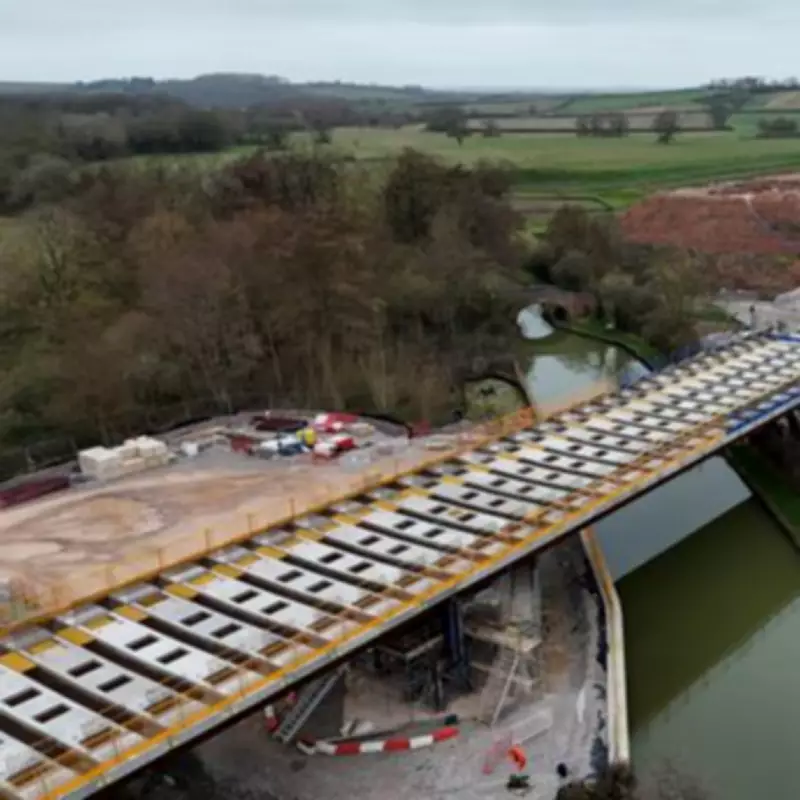

The bridge launch operation began on Wednesday, March 4, and was successfully completed by Thursday, March 5, at 19:00. Engineers employed the proven 'skid shoe methodology' to slide the massive structure across a country road, the canal itself, and the adjacent towpath near Ufton in Warwickshire. Two powerful hydraulic jacks pushed the bridge forward at controlled speeds of up to ten metres per hour.

Specialist materials played a crucial role in the operation, with Teflon-like coated pads minimizing friction and ensuring a smooth sliding process. The weathering steel viaduct was then carefully lowered into its final position and securely fastened, supported by two abutments and two piers positioned on either side of the canal.

Extensive Preparation and Community Considerations

This successful launch represents the culmination of a comprehensive two-and-a-half-year programme of work led by engineers from Balfour Beatty VINCI (BBV), HS2's construction partner. At peak construction, a dedicated team of 40 professionals worked on the project, undertaking numerous preparatory tasks:

  • Installation of 34 piles reaching depths of up to 30 metres
  • Construction of two concrete piers cast parallel to the canal to enhance visual appeal for canal users
  • Building two abutments and installing 37 precast planks that form the bridge deck's foundation
  • Erection of a new retaining wall with seven-metre-deep sheet piles and concrete capping

The new retaining wall replaces the original 'wash wall' and soft bank, believed to have been constructed approximately a century ago when the canal was widened, ensuring the canal's structural integrity throughout the construction process.

Official Statements and Future Work

Harry Toase, Balfour Beatty VINCI's civil engineering lead for the project, expressed pride in the team's accomplishment: "The team has put in a huge amount of work to prepare for the bridge installation and shown meticulous attention to detail throughout to protect the canal and nearby Grade II listed bridge. I'm delighted we've been able to complete the works a week ahead of schedule and thank the local community for their patience."

Vicki Lee, Senior Project Manager at HS2 Ltd, highlighted the broader progress in the area: "Thanks to the hard work of our engineers and site-based teams, we've made good progress in this area over the last 12 months, with completion of the Long Itchington Wood Tunnel and the successful Longhole viaduct slide operation. There's still a vast amount of work to do as we turn our attention to the embankments and cuttings that will link these sections of the railway ahead of track and power being installed."

The 1.5-mile section of the Grand Union Canal affected by the construction has now fully reopened to waterway traffic, restoring normal operations for canal users while marking another step forward in the HS2 project's development.
